Don't lose auditability during CMMS cutover: a stepwise historical work-order migration and validation checklist

Don't lose auditability during CMMS cutover: a stepwise historical work-order migration and validation checklist

Phase-based migration templates and SQL validation scripts that preserve your maintenance history while catching data discrepancies before they disappear

Your CMMS vendor may promise a weekend cutover, but automated scripts often miss contextual maintenance data. Missing priorities, mis-converted labor, and broken audit trails erase the operational intelligence you rely on to run safe, cost-effective facilities.

When mapping errors scramble historical work orders, you lose patterns that drive decisions: recurring failures, overtime drivers, warranty evidence, and compliance records. Teams usually only notice months later—when reports fail, audits surface gaps, or predictive baselines break.

This guide explains a phase-based mapping approach, relationship-level SQL validation, rollback criteria, discrepancy reporting, and monitoring routines to preserve auditability through cutover.

Why CMMS migrations break historical data

Vendor tools handle surface-level mappings—IDs, basic dates, and names—but maintenance data carries operational context. Automated translations frequently flatten that context and produce semantic corruption rather than outright record loss.

Priority mappings often default to a single value, hiding emergency repair patterns. Time formats convert inconsistently across decimal, hour:minute, and timestamp systems, producing large labor variances. Free-text part descriptions turn into generic placeholders that break consumption history.

Finance and compliance suffer when cost fields merge or lose lineage; you may have the same record counts post-migration but lose the meaning needed for budgeting, audits, and predictive maintenance.

The validation blind spot problem

Most teams validate after cutover, which means the source system is already offline when problems surface. That removes the key investigative resource and forces costly fallbacks or rollbacks.

Common vendor checks count records but miss relationship-level corruption: lost asset links, stripped completion notes, or works orders completed before creation. These semantic errors break operational reporting even when totals match.

Phase-based mapping templates that preserve context

Map data before migration, using combination rules that preserve intent (e.g., priority + type → new priority/category). Stage work so the most compliance- and safety-sensitive records move first.

  1. Phase 1

    Critical Compliance Data (Weeks 1–2) — map inspections, regulatory PMs, frequencies, inspector credentials, and corrective actions

  2. Phase 2

    Asset Performance History (Weeks 3–4) — map failure codes, root causes, and repair patterns using combined-field rules

  3. Phase 3

    Labor and Cost Tracking (Weeks 5–6) — convert time formats, map overtime/shift differentials, and handle burden rates explicitly

  4. Phase 4

    Inventory and Parts History (Week 7) — match free-text parts to catalog numbers and preserve both old description and new part ID

Use a one-row-per-field mapping matrix before running ETL. This preserves field lineage, transformation logic, lookup crosswalks, and reviewer sign-off for auditability.

Download a pre-formatted mapping and validation kit to accelerate this work: CMMS historical work-order migration kit.

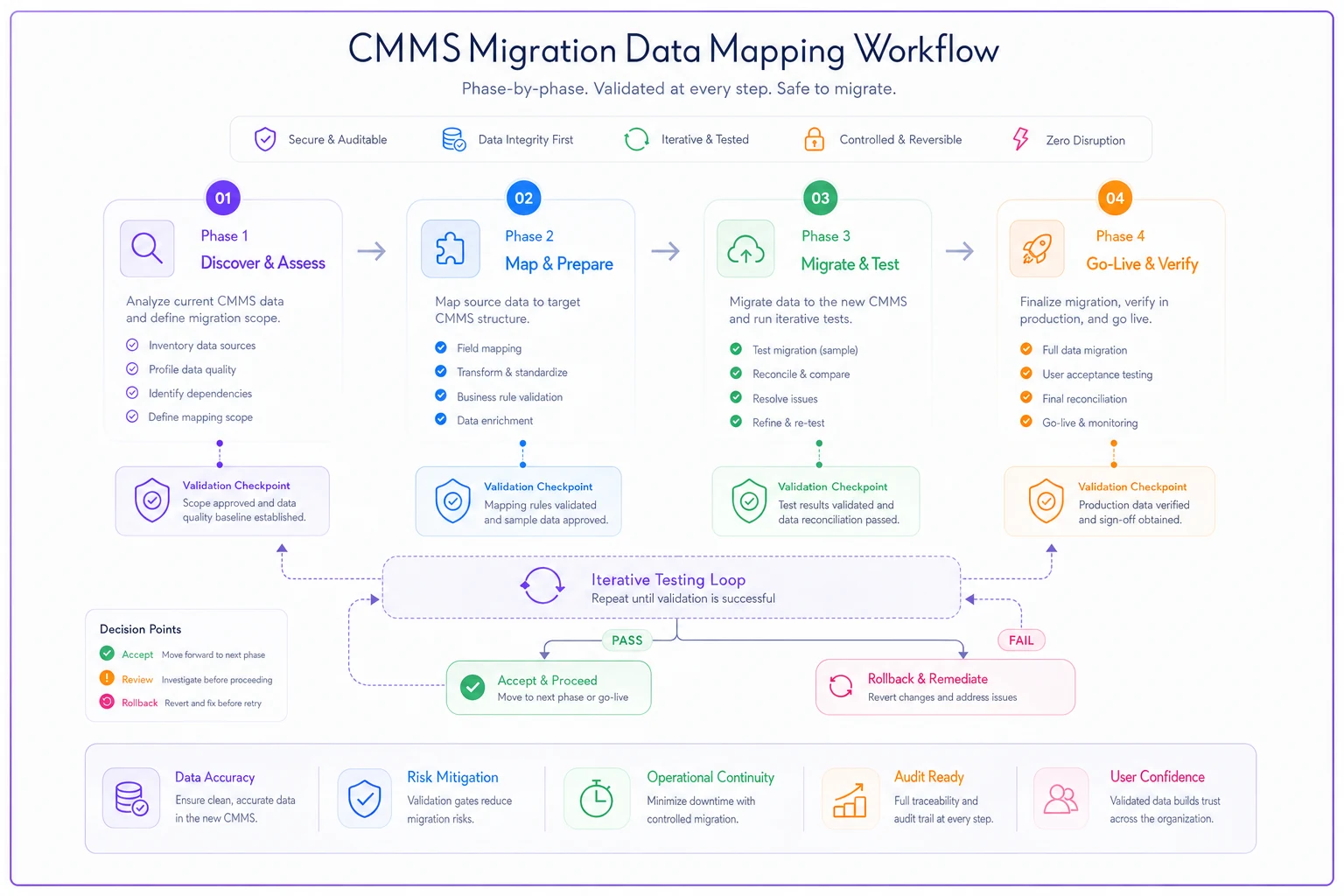

Process diagram

Standard work-order mapping template structure

Document every conversion rule with columns for source, target, data type, transform expression, lookup table, mandatory flag, sample values, reviewer, and review date.

source_object.fieldtarget_object.fielddata_typetransform_expressionlookup_tablemandatory_flagsample_valuesreviewerreview_date
workorder.wostatusmaintorder.statuscodeVARCHAR(20)MAPLOOKUP(statuscode)xwalk_statusTRUECLSD → CLOSEDM. Vance (Ops Lead)2026-03-02
wolabor.actualhoursordertime.billablehoursDECIMAL(5,2)ROUND(actual_hours, 2)N/ATRUE1:30 → 1.50D. Chen (Finance)2026-03-03

SQL validation scripts that catch corruption early

Run relationship-level SQL validations against both systems before cutover. Start with small sample sets and iterate mappings until results align across asset, labor, and cost relationships.

-- Work Order Integrity Checks -- Find work orders with missing asset links SELECT COUNT(*) as orphanedworkorders FROM newworkorders WHERE assetid IS NULL AND oldworkordertype != 'GENERAL';

-- Priority mapping failures SELECT oldpriority, newpriority, COUNT() FROM migrationmap GROUP BY oldpriority, new_priority ORDER BY COUNT() DESC;

-- Labor Hour Validation SELECT MONTH(workdate) as month, SUM(oldsystem.laborhours) as oldhours, SUM(newsystem.laborhours) as newhours, ABS(SUM(oldsystem.laborhours) - SUM(newsystem.laborhours)) as difference FROM migrationcomparison GROUP BY MONTH(work_date) HAVING difference > 10;

-- Cost Reconciliation SELECT workorderid, oldtotalcost, newtotalcost, (oldtotalcost - newtotalcost) as variance FROM costmigration WHERE ABS(oldtotalcost - newtotal_cost) > 100 ORDER BY variance DESC;

Run these queries on a pilot slice (~1,000 work orders), fix mapping rules, then validate on progressively larger samples to catch systemic issues pre-cutover.

Rollback criteria and contingency planning

Define measurable rollback triggers up front. Vague criteria delay decisions and increase risk.

Immediate Rollback Triggers:

  1. More than 5% of work orders fail to migrate
  2. Critical safety PM schedules don't transfer
  3. Active work orders lose status or assignments
  4. Integration with financial system breaks

24-Hour Rollback Triggers:

  1. Historical cost data varies by more than 10%
  2. More than 100 assets show no maintenance history
  3. Compliance reporting queries return empty
  4. Mobile app can't access work orders

One-Week Evaluation Points:

  1. Labor hour reports show 20%+ variance
  2. Parts consumption history incomplete
  3. KPI dashboards can't calculate trends
  4. Technicians can't find historical notes

Document who decides, rollback duration, communications, and which data will be lost if rollback is performed. Some systems cannot cleanly reverse migrations.

Worked discrepancy reports for audit trails

Every discrepancy needs a written record usable by finance and compliance. This is your audit defense when matching cannot be perfect.

  1. Original value from old system
  2. Converted value in new system
  3. Reason for difference
  4. Business impact assessment
  5. Acceptance signature and date

Categorize discrepancies so stakeholders can triage work after cutover.

  1. Category A

    Accepted as-is (minor, usually under $500 or 5%)

  2. Category B

    Flagged for future correction (medium impact, fix within 30 days)

  3. Category C

    Must fix before cutover (breaks compliance, safety, or finance)

Include screenshots, calculation notes, and impact explanations. Track acceptance decisions for later audit review.

Testing with parallel operations

Run both systems in parallel for at least two weeks to validate operational use, not just data parity.

Week 1 Tests:

  1. Pull last year's history for five critical assets
  2. Generate overtime reports for the past quarter
  3. Verify PM schedules for next month
  4. Check parts consumption for top 10 inventory items

Week 2 Tests:

  1. Run compliance reports for the last inspection cycle
  2. Calculate MTBF for problem equipment
  3. Verify warranty claim documentation
  4. Test cost allocation to departments

Document every issue during parallel ops, even minor ones, and link them back to mapping or UI problems.

Historical pattern preservation tactics

Some patterns can't survive direct field mapping. Use alternative preservation tactics to retain institutional knowledge.

  1. Create structured equipment summaries and import them as equipment notes
  2. Build reference lookup tables that map old terms to new terminology
  3. Screenshot key reports from the old system and archive them with timestamps

Preserve both old free-text descriptions and new catalog IDs for parts to aid technicians during transition.

Department-specific validation checklists

Different stakeholders care about different integrity checks. Provide tailored checklists so each group can validate the migration against their priorities.

Operations Manager Checklist:

  1. Equipment criticality rankings preserved
  2. Failure patterns visible in history
  3. Downtime records accurate
  4. Production impact codes mapped

Compliance Officer Checklist:

  1. Inspection dates and results transferred
  2. Inspector certifications documented
  3. Corrective action tracking intact
  4. Audit trail complete with signatures

Finance Controller Checklist:

  1. Labor costs match payroll records (within 2%)
  2. Parts costs align with inventory value
  3. Department allocations preserved
  4. Budget variance reports reproducible

Maintenance Supervisor Checklist:

  1. Technician assignments transferred
  2. Recurring PM schedules active
  3. Work instructions accessible

Department-specific lists make responsibilities explicit and reduce the chance that an IT-centric migration overlooks operational dependencies such as permit numbers or asset hierarchies.

Post-migration monitoring period

The first 90 days reveal issues testing missed. Use a structured monitoring cadence to catch drift early.

  1. Days 1–30

    daily checks for work order creation, PM generation, mobile sync, and cost accumulation

  2. Days 31–60

    weekly reviews of historical reports, KPIs, inventory consumption, and labor reconciliation

  3. Days 61–90

    monthly analysis of failure trends, compliance reports, budget variances, and predictive baselines

Track a migration scorecard with metrics like report accuracy, successful work order completions, and user adoption. Link issues to mapping documentation to identify root causes.

Automation opportunities in migration management

AI-powered tools can accelerate mapping by learning actual field usage patterns instead of relying on labels. They can surface contextual mappings that humans miss at scale.

Automation can also run real-time validation during migration, alerting on anomalies (e.g., completion dates before creation) before those patterns replicate across thousands of records.

Making migration decisions under pressure

Migrations often happen under time pressure. Prioritize preserving core operational capabilities—identifying problem equipment, tracking compliance, and managing costs—over perfect field-for-field replication.

  1. Focus decisions on whether operational visibility and auditability are preserved
  2. Use discrepancy reports to accept immaterial differences formally
  3. Invest in one extra week if core functions would be impaired by a rushed cutover

Treat historical maintenance data as an asset. Phase-based mapping, relationship-level SQL validation, firm rollback criteria, and structured discrepancy reporting preserve auditability and maintain operational intelligence through cutover.

Use the provided mapping and validation kit to jump-start your planning: CMMS historical work-order migration kit.
